Driving a bus down the railway tracks

Next time you turn up to a Melbourne railway station, only to discover that buses are replacing trains for level crossing removal works, and the bus stop is an epic walk away, just remember that it doesn’t have to be that way – once upon a time public transport operators actually used to put some effort into making the interchange between bus and train easy.

Today we look at the Middleborough Road Project of 2007, which isolated the Lilydale and Belgrave lines for six weeks while a new rail cutting was excavated under Middleborough Road at Box Hill.

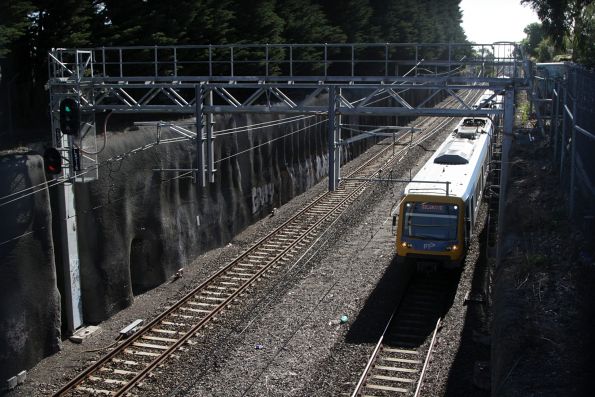

X'Trapolis trains leads a down Belgrave service through the Middleborough Road cutting at Laburnum

Trying to catch a bus at Box Hill

If you’ve ever had the misfortune of trying to catch a bus at Box Hill station, you know how convoluted the route is – first a set of escalators to exit the platform.

Escalators down to Box Hill platform 2 and 3

Then futz around with the ticket gates.

Ticket barriers at the entrance to Box Hill station

Dodge clueless shoppers inside Box Hill Central shopping centre.

Looking down on Box Hill Central shopping centre and station concourse from the bus deck

Then take a vertigo inducing trip up another set of escalators into the middle of the shopping centre atrium.

Escalator to the Box Hill bus interchange heads right into the middle of the shopping centre atrium

And you’re finally there.

Ventura bus #1214 8263AO on route 765 at Box Hill station

So what did the Middleborough Road Project do?

Then-rail operator Connex still called in the buses.

Up to 48 buses will run in peak periods between Box Hill and Blackburn.

The trip between Blackburn and Box Hill should take no longer than 17 minutes, including time to board and disembark, and walk between the bus and the train.

During peak periods and throughout the day on weekdays, a continuous shuttle bus service will operate between Box Hill and Blackburn. Buses will depart as soon as they are full and return as soon as the passengers on board have disembarked.

After 9pm on weekdays and on Saturdays, Sundays and public holidays, buses will operate to a set timetable. This will correspond to the temporary timetables for train services.

But built two temporary bus interchanges for them to operate from.

Blackburn

Buses will depart a temporary bus interchange just to the north of the station. Up to eight buses can stop in this interchange which will be built over an existing small car park and on the station side of Railway Road.

An extra DDA compliant crossing point is being built to the west of the station to accommodate passenger movement to and from the buses. This walkway will cross from the end of platforms 1 and 2, north to temporary bus interchange. It will not extend southwards to South Parade.

In addition, a number of gateways will be made in the fence separating platform 3 (which is the northern-most platform) and the adjacent temporary bus interchange in the car park.

Box Hill

A temporary bus interchange will be built next to the station, under Box Hill Central. The railway tracks, which are not in use during the shutdown, will be covered and the interchange built over them.

The interchange will have capacity for up to eight buses at a time to load/unload.

A pedestrian bridge, with stairs, will link platforms 2/3, with the bus interchange.

And how it worked

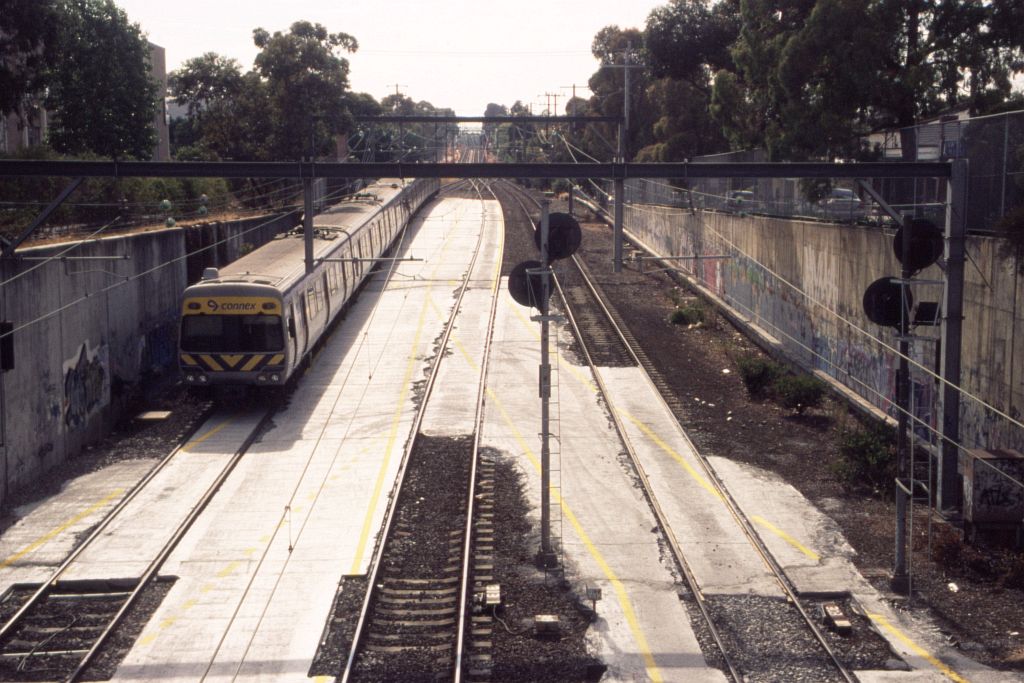

The interchange at Box Hill was the most impressive, with concrete being laid right over the top of the railway tracks, but in a way that trains could still run.

Weston Langford photo

So after the railway was shut down, buses could drive right in along the tracks.

Weston Langford photo

Stopping at a temporary bus interchange built on the tracks beneath the shopping centre.

Chris Gordon photo

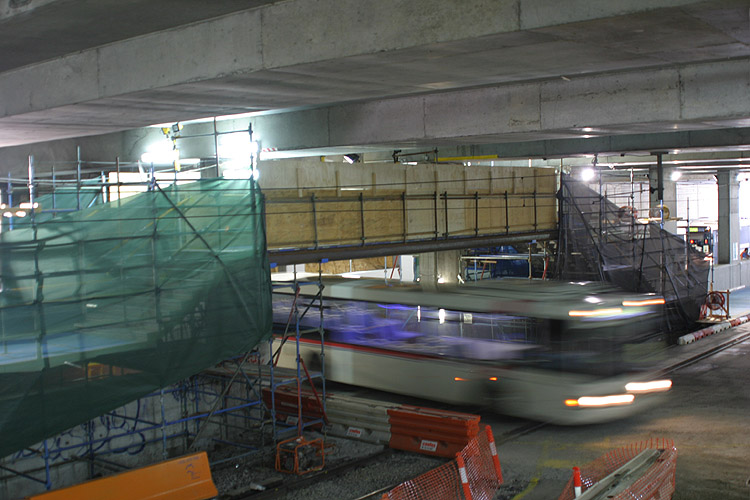

Passengers being able to connect to trains on platforms 2 and 3 using a temporary footbridge over the bus roadway.

Chris Gordon photo

Buses then headed for Blackburn along the railway tracks.

Weston Langford photo

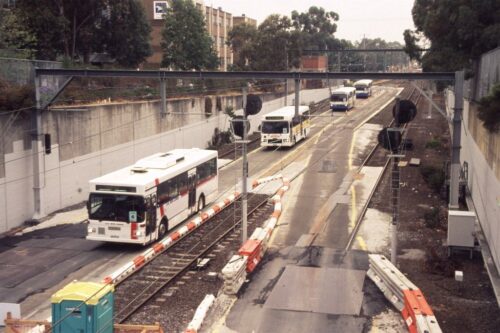

Exiting onto Whitehorse Road via a ramp at Linsley Street.

Weston Langford photo

And today?

2023 saw buses replace trains between Camberwell and Box Hill for level crossing removal works at Mont Albert Road, Mont Albert and Union Road, Surrey Hills – so how much effort was put into the replacement buses for that project?

At Camberwell station passengers had a short walk from the platforms to a shelter on Cookson Street to wait for buses.

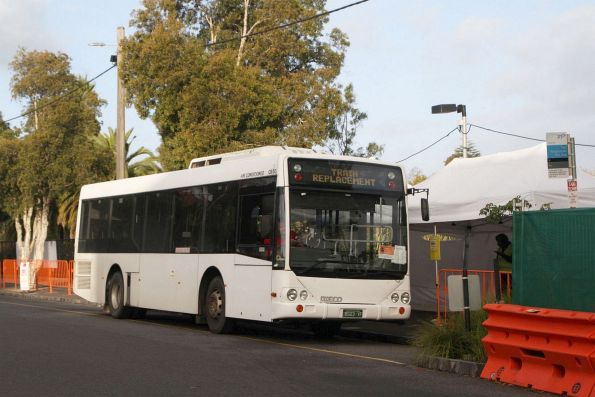

Sundancer bus BS03YF at Camberwell station on a rail replacement service

With traffic controllers guiding buses out onto Burke Road.

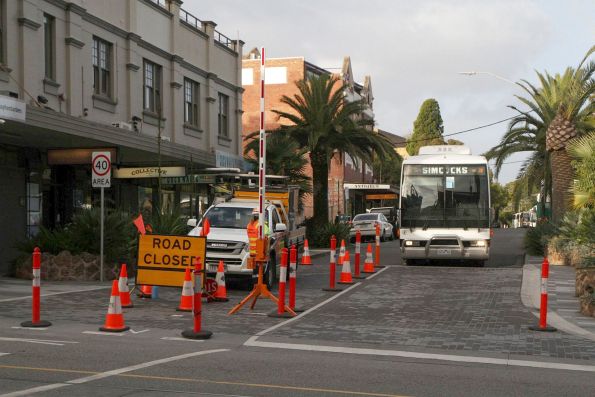

Simcocks' coach #4 0204AO departs Camberwell station on a rail replacement service

But at the Box Hill end passengers got nothing – having to fight their way out of the station and along the Market Street mall to Whitehorse Road, where the buses would stop outside the shops.

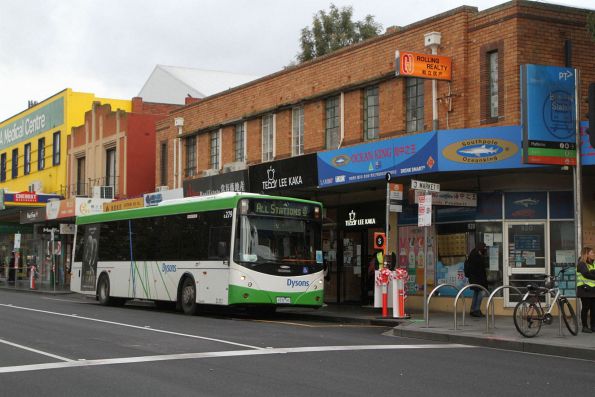

Dysons bus #279 4332AO outside Box Hill station on Whitehorse Road

In all an incredible contrast to the world of 2007 – we now grade separate dozens of level crossings each year without blinking, but put almost zero effort into making life easy for the passengers having their travel disrupted.

Further reading

Liked it? Take a second to support Marcus Wong on Patreon!
Become a patron at Patreon!
You can leave a response, or trackback from your own site.

6 Responses to “Driving a bus down the railway tracks”

  1. Damian Zito says:

    I hope PTV get your emails!

  2. Jesse says:

    That Middleborough Rd grade separation was the pre-LXRP Proof-of-concept prototype trial run.
    The actual first target for a LX removal was Springvale Rd at Nunawading, but given how significant that arterial was, they didn’t want to risk screwing it up first try on such a busy corridor. So they selected Middleborough Rd (still in needing of grade separation and curve easing) as a bit of a prototype project and trial run to practice with the sort of fast-moving occupation and bus replacement they needed for Springvale Rd.
    Springvale Rd LX removal happened in 2009-10, as did Springvale, Sunshine and Mitcham (all in 2014) before the now-successful program got rebranded as LXRP in 2015.

    Maybe they expected 6 weeks of mainline shutdown to be more reputationally damaging than it ended up being, hence why they went to such effort? Now that some sort of a shutdown happens every other week, maybe the thinking is that we’re so used to it that such inconvenience doesn’t actually result in reputational damage. If so, that is a shame.

  3. Dark Knight says:

    A unique, likely once in a lifetime arrangement; even the last major shut when they built Union station operational trains was on the “wrong side” although with having just one operating platform was less than ideal that that and lack of swift hop on and off for drivers meant rarely on time running (story for another time).

    Depending on what’s installed for the SRL project it will be the only reason for major long disruption at Box Hill; would see one of two things, trains terminate at UNN and BBN or finally fable platform 1 being made operational along with platform 4 with the centre platform closed in order for digging the subject connection to the new SRL platforms.
