Four week Sunbury shutdown for Furlong Main

At the moment there is a four week disruption to the Sunbury line in order to place the tracks underground at Main Road and Furlong Road, and open new railway stations at St Albans and Ginifer. I’m curious as to why such a length of time is required to complete this set of works, when other projects in Melbourne suggest it could have been achieved with less disruption.

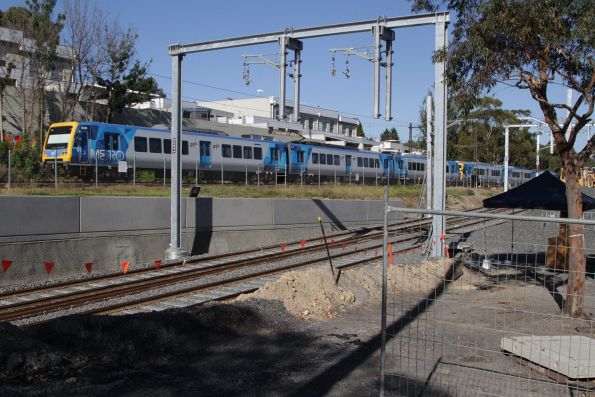

X'Trapolis 64M passes the yet to be commissioned low level tracks at the up end of Gardiner station

Some background

Level crossing removal projects in Melbourne can be classified into two groups – “online” and “offline”.

Offline projects cause the least inconvenience to rail users – a new railway line and station is built beside the existing tracks while trains continue running, with the only disruption being the week or so it takes to disconnect the old tracks and hook in the new ones.

Examples of off line projects include Boronia Road at Boronia station, Springvale Road at Nunawading station, and Burke Road at Gardiner station.

However in areas where there is no spare land inside the railway corridor, offline construction is not possible, forcing the new tracks to be constructed on the same alignment as the existing, requiring the shut down of rail services while the works take place.

Examples of online projects include the Middlebrough Road level crossing at Laburnum station, the Rooks Road level crossing at Mitcham, and the Ormond, McKinnon and Bentleigh trio on the Frankston line.

So what about St Albans and Ginifer?

The grade separations at Furlong Road and Main Road are being built offline, thanks to the abundance of land adjoining the existing Sunbury line corridor.

EDI Comeng departs Ginifer station with a down Watergardens service

The first stage of works was the relocation of signalling cables, so that excavation of the new tracks would not affect rail services.

Signalling cable relocation works in preparation for the Main Road grade separation works at St Albans

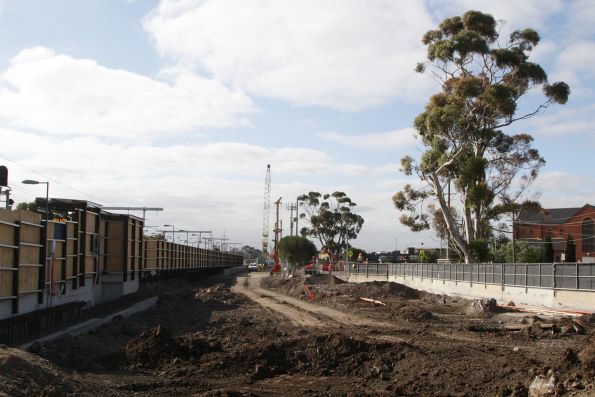

Land was cleared beside the existing railway stations, so that the new low level stations could be built.

 Cleared land to the west of St Albans platform 2

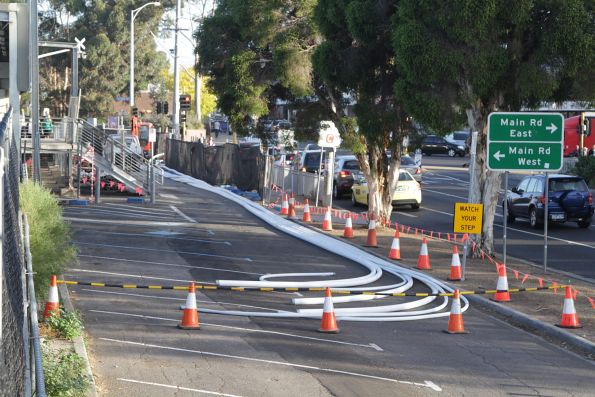

At separate times Main Road and Furlong Road were closed to road traffic.

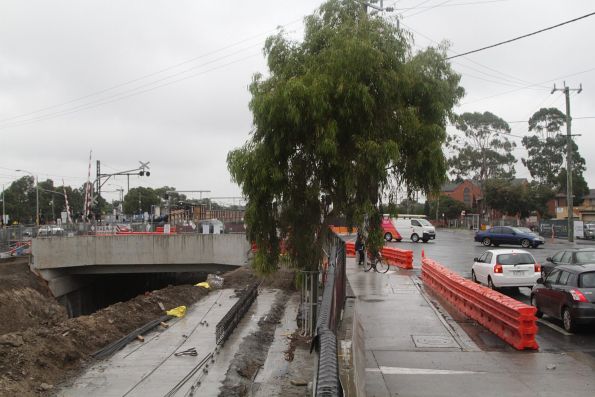

Main Road closed at St Albans station to allow the bridge over the future low level tracks to be built

These shutdowns allowed concrete bridges to be constructed over the future railway.

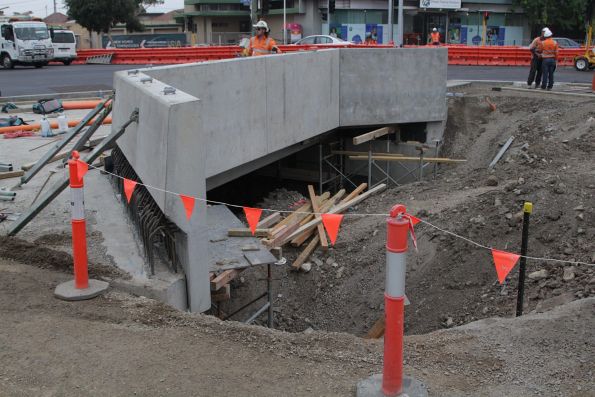

Bridge in place to carry Main Road over the future low level tracks at St Albans station

To reduce the amount of time road traffic was disrupted, just enough of the bridge foundations and deck were constructed to span the gap – allowing the rest of the rail cutting to be excavated as time permitted.

Retaining walls and the Main Road bridge completed, but the trench is yet to be dug either side

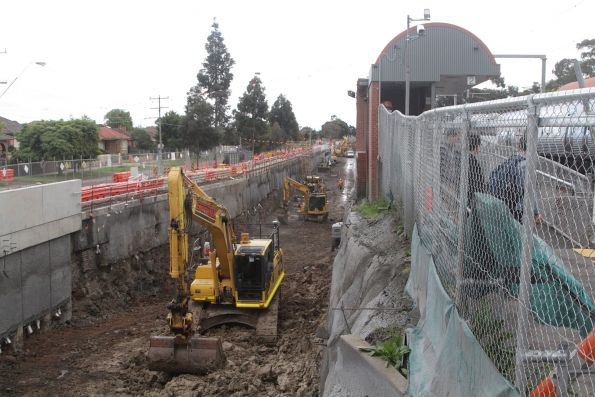

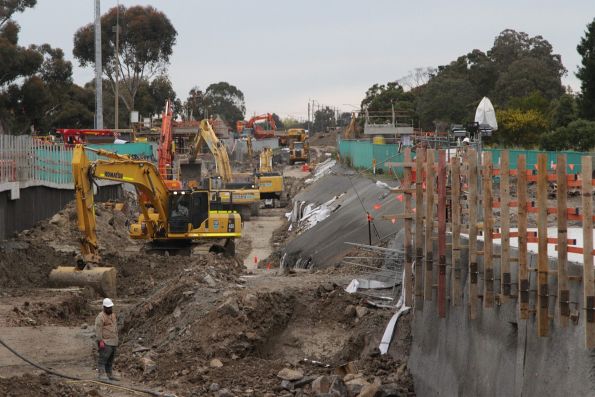

Piling works commenced to construct the future cutting walls.

Piling works commence at the down end of the removed platform 2

Then the excavators moved in to create the rail cuttings.

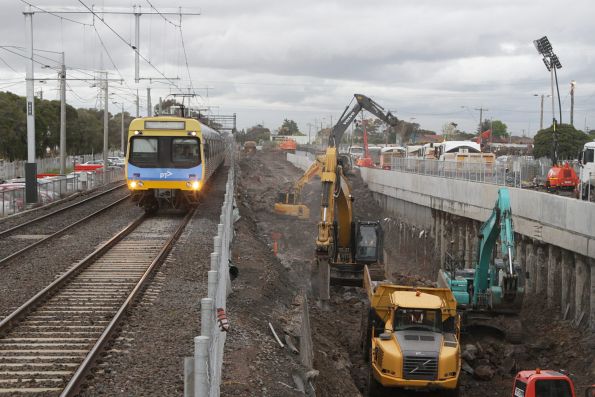

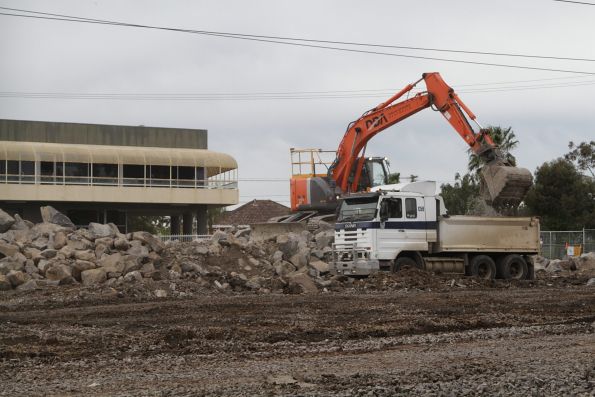

Removing dirt from the rail cutting at the down end of the new Ginifer station

With none of this affecting passing trains.

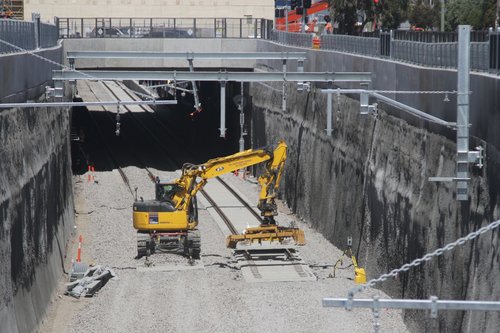

Down Comeng train approaches St Albans station, as excavators remove rock from the future rail cutting

Work also started to fit out the new stations – with station buildings, platform, lamp posts, staircases and lift wells all being put into place.

As the four week long shutdown of the Sunbury line from October 4 was fast approaching, and a limited amount of time available to complete the works while trains are not running, one would assume that any task that could be completed while trains are still running would have been completed. But the reality looks different.

This was Ginifer station on September 29 while trains were still running – the new level station was just a bare concrete shell, with no tracks to be seen.

EDI Comeng passes work on the new low level station at Ginifer

And here is the view north of Main Road at St Albans – an empty rail cutting, with no progress on the new tracks, signalling equipment, or overhead structures.

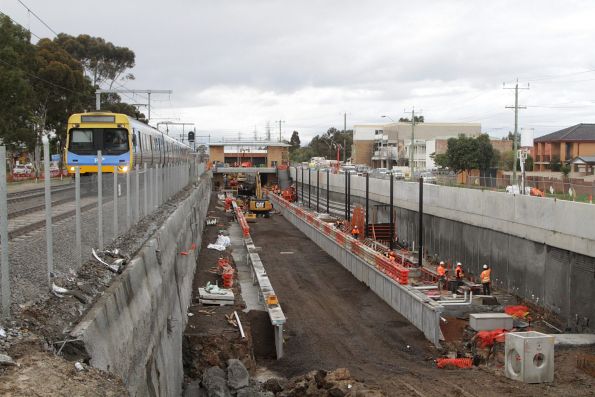

Citybound train approaches St Albans station, passing the almost complete rail cutting

Maybe taking the trains away would mean work can speed up? Revisiting the Main Road overbridge on October 16, two weeks into the shutdown, suggests otherwise – the only change to the scene is the removal of the old tracks, and the addition of overhead structures.

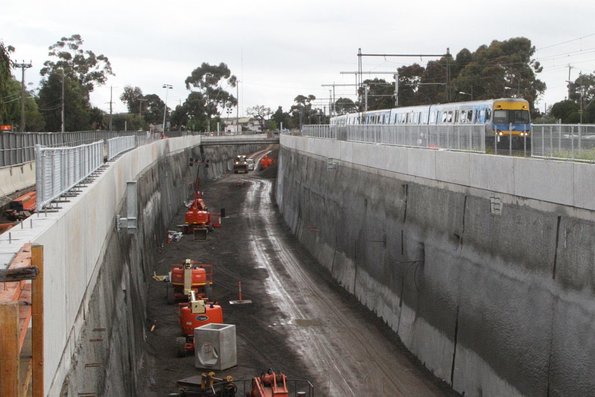

Looking over the trackless rail cutting north of St Albans station

So why was a four week shutdown of trains required at St Albans, when other projects required far shorter periods of time?

Some theories

My first theory was the size of the works – despite being a single project, the grade separation through St Albans requires four connections to the existing railway tracks – thanks to the rollercoaster trench alignment through Ginifer and St Albans stations. However this theory is easier to discount – each tie in could be constructed in parallel, assuming the availability of enough equipment and workers.

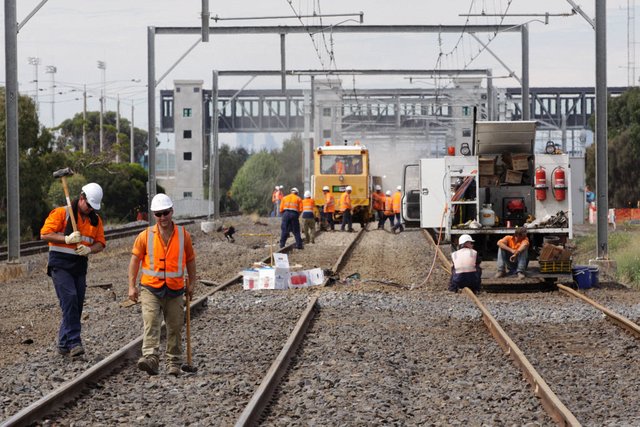

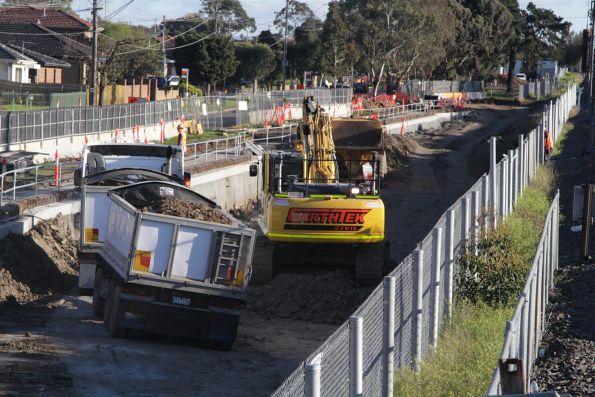

Track workers at the down end

Another theory was the availability of railway signalling engineers. With multiple level crossing removal projects underway in Melbourne at the same time and a critical shortage of engineers in Victoria, perhaps the only way to find staff available to work on the Furlong Main project was to timetable it over a longer period?

Rail staff prepare new signalling equipment near Ginifer station

Ground conditions are another variable. Melbourne’s west lies on a bed of basalt all the way down, which unlike the sand found under the recent Frankston line works, need to be slowly broken up before it can be hauled out of the rail cutting.

Excavator moving basalt from the rail cutting at the down end of St Albans

The presence of rare native plants along the railway reserve is another possible factor. Native grasslands are found at Ginifer and St Albans, occupying land that could otherwise be used as part of an offline grade separation, as well as restricting easy access to the tracks during construction works.

Alstom Comeng 678M on the up at Ginifer

And the final wild card is politicians, as this media release from the Minister for Public Transport dated October 2016 shows.

St Albans Level Crossings Gone By The End Of The Year

The two dangerous and congested level crossings in St Albans that the Andrews Labor Government is removing will be gone by the end of the year – more than six months earlier than promised.

Minister for Public Transport Jacinta Allan announced that the construction blitz beginning today will see the crossings at Main and Furlong Road removed well ahead of schedule.

Maybe the trains have been taken away so that the project can be finished sooner, so that the politician’s level crossing removal tally can keep on ticking along?

The official word

I ended up emailing the Level Crossing Removal Authority as to why a four week shutdown of trains was required for the Furlong Main works when projects such as Bourke Road did it much quicker, and this was their answer:

The Burke Road level crossing removal was similar to what we are doing out in St Albans with constructing the new railway corridor next to the existing however the ground conditions are very different.

In St Albans we have a lot of basalt rock which is very hard to break. These ground conditions are also where we are connecting the existing track with the new lowered railway line and are longer than Burke Road.

This means we need to excavate at four separate locations where we are tying in along with some temporary walls closest to the existing railway line and all during October.

We are also removing the two existing stations which are right next to the new railway corridor. For safety reasons we could not have trains running whilst we undertake these works.

The project in St Albans also has quite a few areas which are environmentally protected therefore there is limited access in and around where we are constructing the new lowered railway corridor.

Difficult ground conditions? Check!

Working around grasslands reserves? Check!

The long connections between the new and old tracks were something I’d missed, but as you can see in my photo taken north of St Albans halfway through the shutdown, the scale of the work is apparent.

Looking north to excavators moving rock from the rail cutting north of St Albans station

But the proximity of the running lines to the new stations is a little trickier to see, such as this view behind the old Ginifer station.

Rail cutting well underway behind the existing station at Ginifer

However the Level Crossing Removal Authority’s Facebook page takes a closer look, such as this view of the temporary wall that was required to separate the original upper level tracks from the new low level platforms at Ginifer station.

Temporary walls also look to have been used on the eastern side of the new St Albans station.

So where does the truth lie?

In reality I think the truth lies somewhere in the middle – there are plenty of good reasons why the works at St Albans are taking longer than other similar looking projects in Melbourne, but there is evidence to suggest a shorter disruption to rail service could have been possible if more preparatory work was completed before the main shutdown.
