Stuck truck under the Napier Street bridge

Trucks getting stuck under the Montague Street bridge is a running Melbourne joke, but there is another bridge that gets hit far more often, but where the risk to the public is far worse – the Napier Street bridge in Footscray.

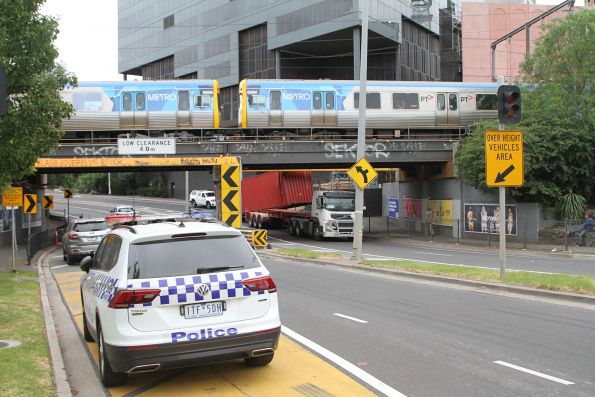

Victoria Police in attendance at Napier Street after the driver of a eastbound container truck struck the bridge

The incident

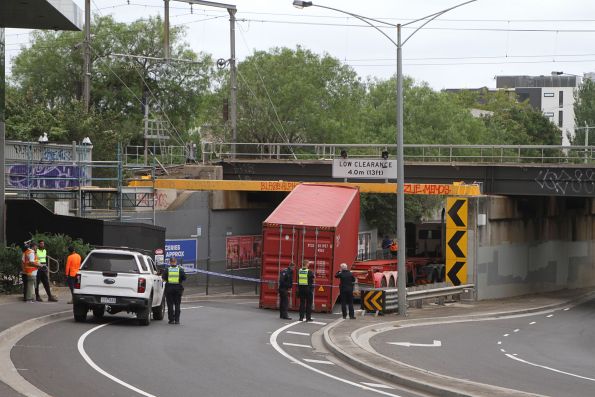

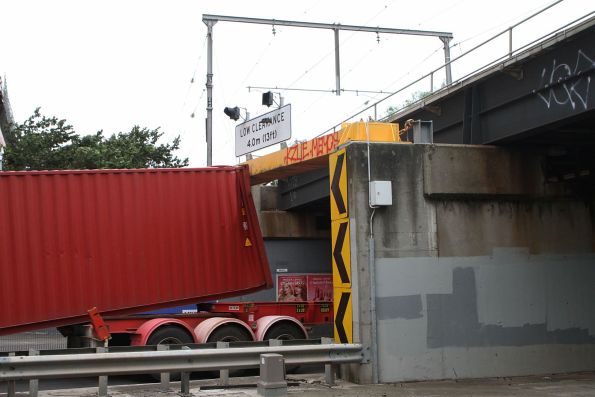

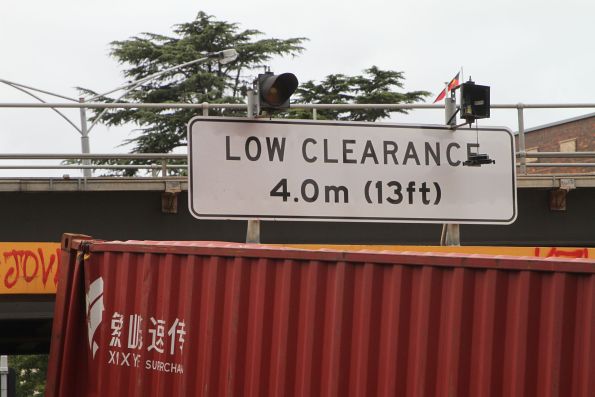

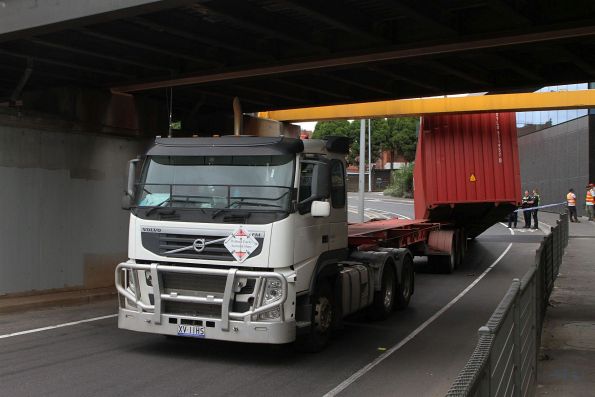

On Sunday 3 March a so-called ‘professional’ driver of a container truck loaded with a single ‘high cube’ 40 foot ISO shipping container bound for the Port of Melbourne tried to make it under the 4.0 metre clearance Napier Street bridge, but ignored the warning signs – striking the bridge and dislodging the container from the truck.

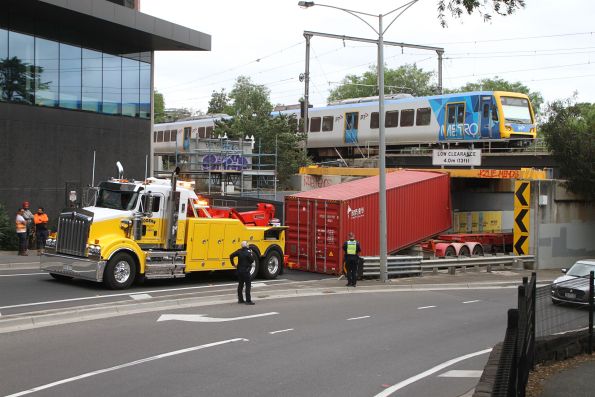

By the time I came past trains were already running again following an inspection of the bridge, and Victoria Police were in attendance – not hard, given their police station is next door!

Victoria Police in attendance at Napier Street after the driver of a eastbound container truck struck the bridge

The damage

The 40 foot container had been dislodged from the trailer, and hanging at a perilous angle, almost ready to fall onto the footpath.

40 foot container dislodged from the truck after it hit the Napier Street railway bridge

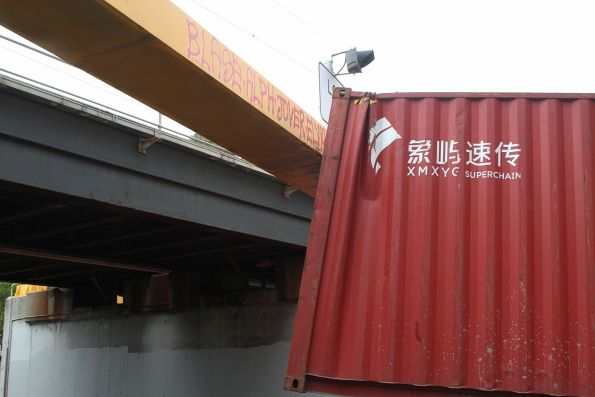

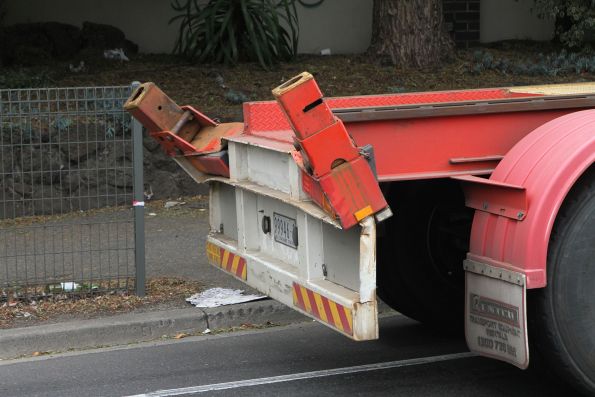

The bridge protection beam taking the hit rather than the bridge.

40 foot container dislodged from the truck after it hit the Napier Street railway bridge

The impact speed must have been high, as the bridge warning lights had been dislodged.

Damaged warning lights after a 40 foot container hit the Napier Street railway bridge

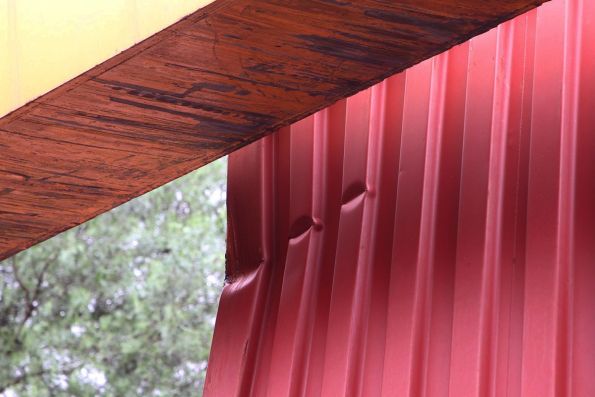

And the steel container deformed.

40 foot container bashed up after it hit the Napier Street railway bridge

An impact mark from the bridge protection beam visible to one side.

40 foot container bashed up after it hit the Napier Street railway bridge

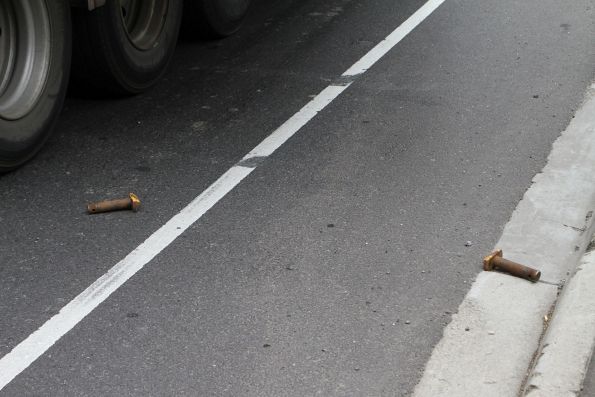

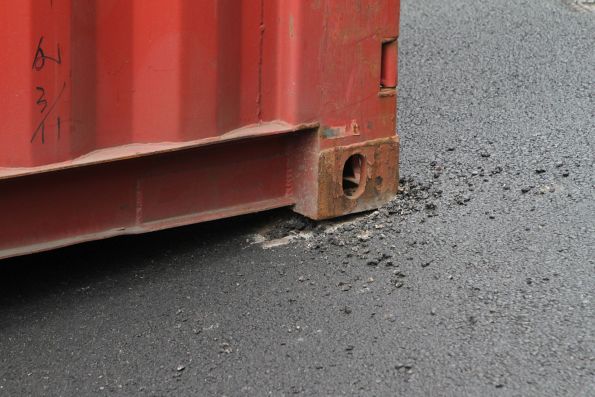

Dislodged container twistlocks on the ground below.

Twistlocks on the ground after a 40 foot container was dislodged from the truck after it hit the Napier Street railway bridge

A hole in the fresh asphalt where the container fell to the ground.

Fresh asphalt beat up after a 40 foot container hit the Napier Street railway bridge and fell onto the road

Recovery time

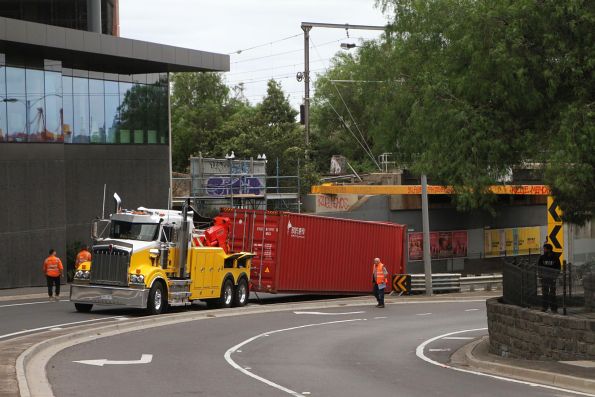

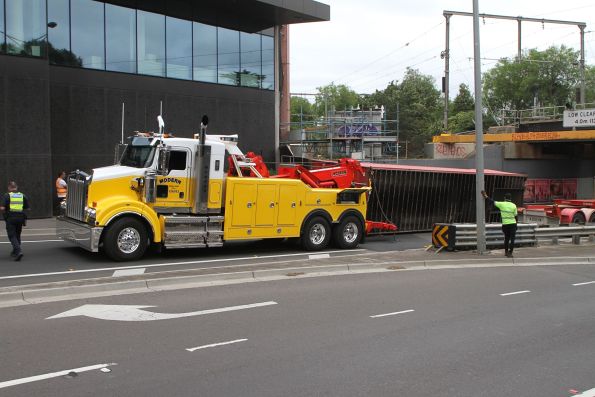

The truck operator called up mobile crane to assist with the recovery operation.

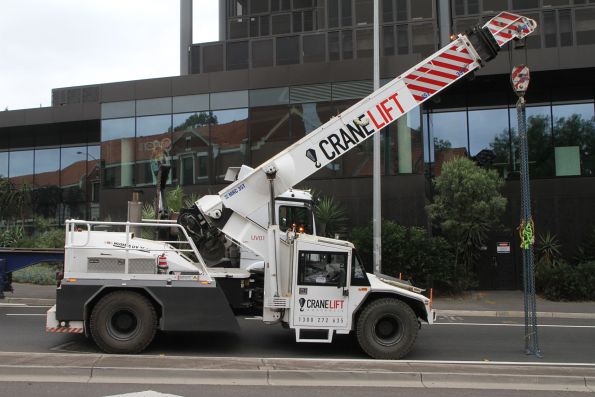

Humma crane in attendance just in case

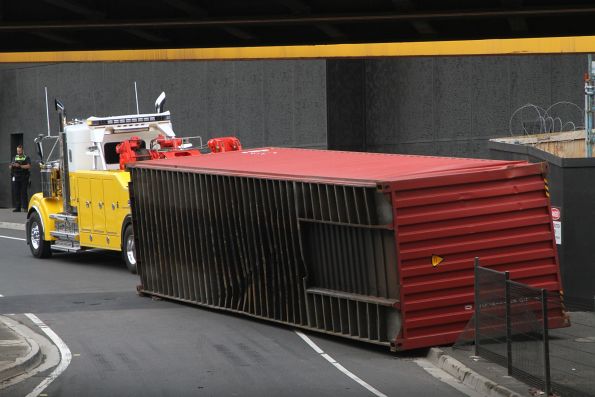

But it wasn’t needed – a heavy tow truck was used to drag the container away from the truck.

X'Trapolis 199M passes a 40 foot container stuck under the Napier Street bridge, heavy tow truck ready to drag off the truck

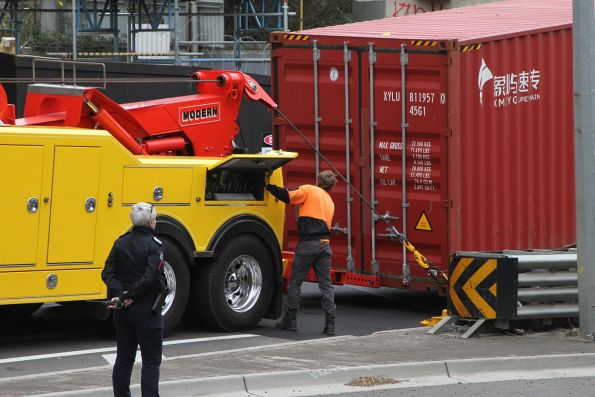

Chains and the rear boom used to lift up the rear of the container.

Heavy tow truck ready to drag off the 40 foot container off the truck stuck under the Napier Street bridge

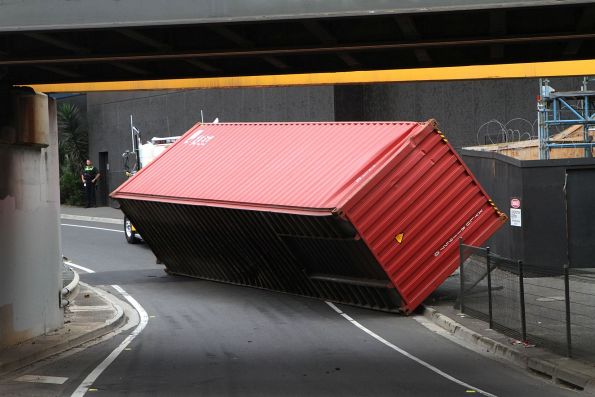

Which then topped over sideways.

And over it goes - 40 foot container falls onto it's side after being dragged off the truck

Crushing the fence intended to ‘protect’ pedestrians from road vehicles.

40 foot container sitting on it's side after being dragged off the truck

I don’t think that was how they intended the recovery to go!

At least the semi-trailer was now free.

Beat up container twistlocks on the truck that hit the Napier Street bridge

But in need of repair – the rear container twistlocks bent out of position.

Beat up container twistlocks on the truck that hit the Napier Street bridge

Another crack

After a bit of maneuvering, the heavy tow truck was able to pull the 40 foot container back upright.

Heavy tow truck pulls the 40 foot container back upright

And then pull it clear of the bridge.

Heavy tow truck drags the 40 foot container clear of the bridge

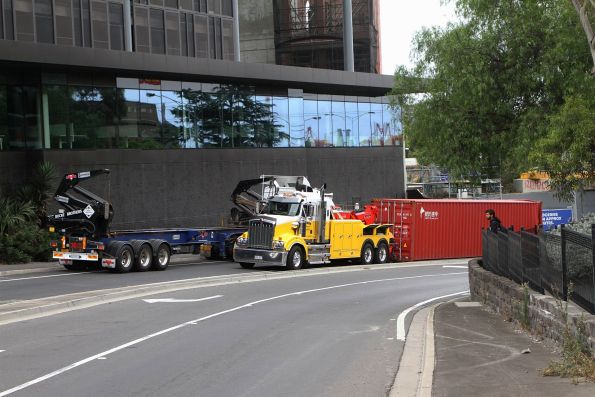

Allowing a waiting sidelifter truck to pull up alongside.

Sidelifter truck ready to pick up the damaged 40 foot container

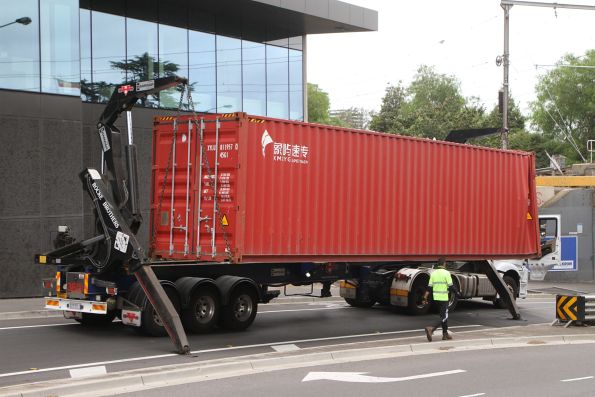

Lift the damaged container onto the sidelift trailer.

Sidelifter truck picks up the damaged 40 foot container

And take it away.

Sidelifter truck takes the damaged 40 foot container away

Allowing the eastbound lanes to be reopened.

Road traffic back to normal beneath the Napier Street bridge in Footscray

All up the recovery effort took an hour to complete.

So why is the Napier Street bridge worse?

The Montague Street might be notorious for bridge strikes in Melbourne.

A1.253 passes over the Montague Street bridge

But the bulk of impacts in South Melbourne are just weekend warriors on car licences driving rental trucks when moving house – not ‘professional’ drivers with a heavy vehicle licence – and a four tonne steel shipping containers falling off a truck is far more dangerous to other motorists than the body of a pantech truck getting a little beat up.

In addition the statistics don’t lie – the the Napier Street bridge was struck 37 times by heavy vehicles between 2018 and 2022, while the Montague Street bridge was only hit once in 2021.

One possible solution – the Port Rail Shuttle project, paused back in 2015, but ready to start operation ‘soon’.

Looking west towards the new level crossing between Intermodal Way and the Coode Road rail terminal siding

Footnote

And a bit of a laugh – a petition to “Paint Footscray’s Napier Street Bridge With Scary Shark Teeth“.
