Inspecting the West Gate Bridge

The West Gate Bridge is a key part of Melbourne’s transport infrastructure, connecting the east and west sides of the city since it was opened to traffic in 1978. But how does VicRoads ensure the bridge stays in good condition?

West Gate Bridge at sunset

Some history

The 2.5km long West Gate Bridge consists of two concrete box girder approach viaducts, 871m and 670m long, and an central 848m cable stayed steel box girder span over the Yarra River. The pier height varies, with a maximum height is 48m.

Tug heading out to sea under the West Gate Bridge

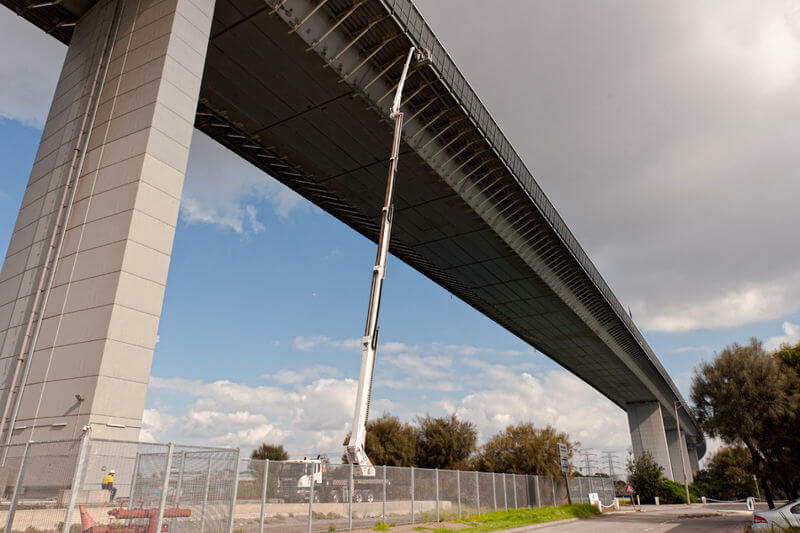

Except for the portion over the river, practically the full length of the bridge is above vacant land and can be accessed from below by means of elevated work platforms.

Ace Tower Hire photo

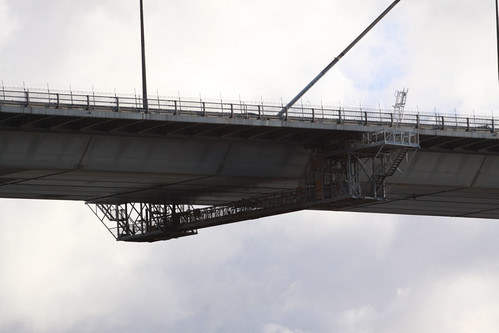

But for the portion of the bridge over the river, four permanent maintenance platforms were provided beneath the steel spans.

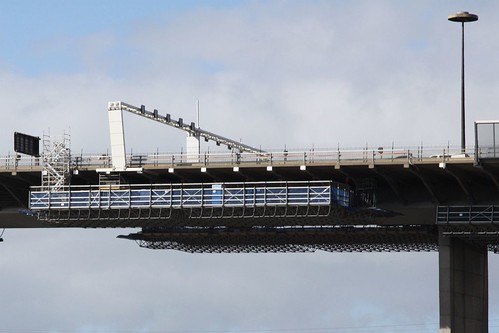

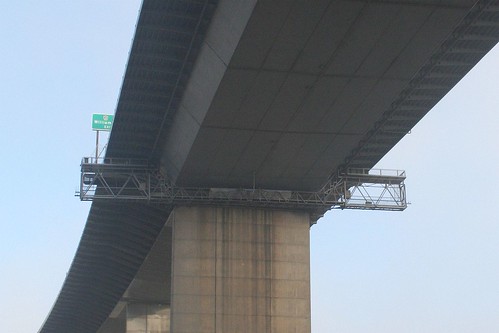

Bridge inspection gantry parked at the western end of the steel span, one of four such gantries on the West Gate Bridge

Operated from two runway beams, three of the platforms dated back to the construction of the bridge in the 1970s, with a fourth installed in 1995, these gave access for routine inspections, as well as minor works such as washing and patch painting.

Of the the maintenance gantries under the main cable stayed span

Upgrade time

In 2006 the State Government announced that they would upgrade the West Gate Bridge to carry an additional lane of traffic, taking it to five in each direction.

Outbound on the West Gate Bridge at Port Melbourne

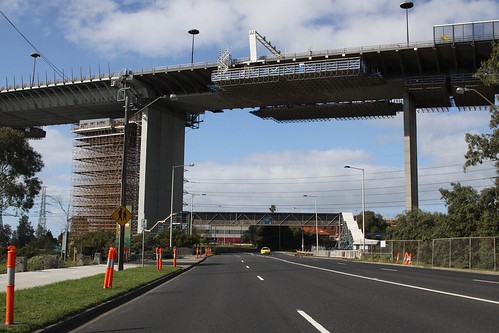

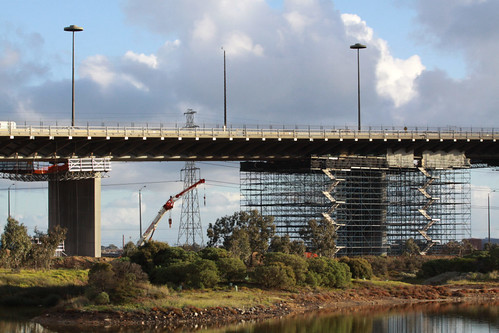

Scaffolding was setup underneath the bridge to allow the necessary strengthening works to take place.

More scaffolding

Including suspended platforms.

West Gate Bridge suicide barriers not quite finished

And an elevated lunch room!

Work continuing on the West Gate Bridge upgrade project

The most noticeable change being the outriggers added to the steel span to support the load from the additional traffic lane.

Strengthening works on the steel box girder of the West Gate Bridge

But this presented a problem – it would block the passage of the existing maintenance platforms.

Two options were considered – a replacement system of maintenance platforms, or the acquisition of a mobile bridge inspection platform that would be deployed as needed.

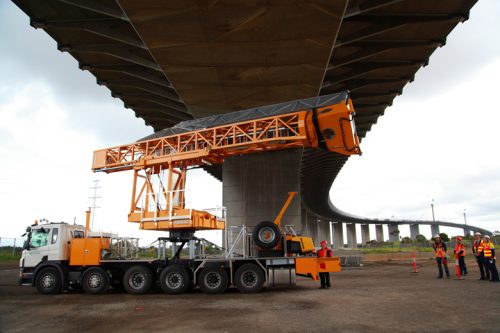

The solution – an upside down crane

This weird looking thing is a MBI 200 under-bridge access unit, custom designed by Moog GmbH in Germany specifically for the Westgate Bridge.

Victorian Government photo

The State Government boasting in a September 2012 media release.

Australia’s largest Mobile Bridge Inspection Platform will improve access for maintenance inspections on Victoria’s most iconic bridge, Minister for Roads Terry Mulder said today.

Roads Minister Terry Mulder announces a mobile bridge inspection platform will replace permanent hanging inspection platforms for the West Gate Bridge, providing more efficient and cost effective maintenance.

Mr Mulder said the mobile bridge inspection platform would replace permanent ‘hanging’ inspection platforms for the West Gate Bridge, providing more efficient and cost effective maintenance.

“Mobile bridge inspection platforms are becoming more and more common on large bridges around the world as sustainable and cost effective maintenance tools,” Mr Mulder said.

“I’m very pleased to launch this innovation in Victoria, which will provide a great cost saving, as we do away with expensive and heavy permanent inspection platforms that span nearly one kilometre.

“It also improves access to all areas under the West Gate Bridge with an expanding platform that can extend for 20 metres under the bridge deck.

‘This will make it is easier for maintenance inspectors to see more of the underside of the bridge and because it is mobile, they can manoeuvre it to exactly where they want to be,” Mr Mulder said.

In what can only be described as an ‘upside down crane’, the unit includes a 17 metre boom arm that extends over the bridge barriers and lowers the inspection platform in place.

In order to stabilise such a large operation, the base truck, at 12 metre in length, has six axles when in operation and weighs 37 tonnes.

“The Mobile Bridge Inspection Platform has come to Australia all the way from Germany and is a great example of Victoria delivering innovative solutions to manage key infrastructure well into the future.”

When in operation, the unit will require two lanes to be closed on the West Gate Bridge to complete an inspection. These will be conducted during off peak periods and at night to reduce delays to traffic.

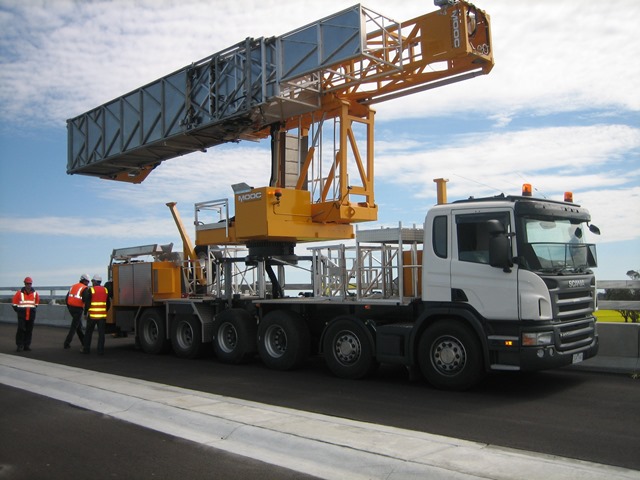

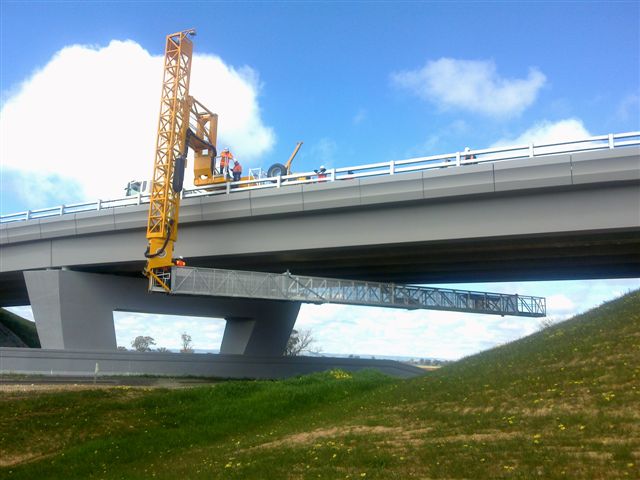

The bridge inspection unit completed initial testing on the yet to open Nagambie Bypass.

Moog GmbH photo

Showing off the capability of the machine.

Moog GmbH photo

And looking like a transformer in the process.

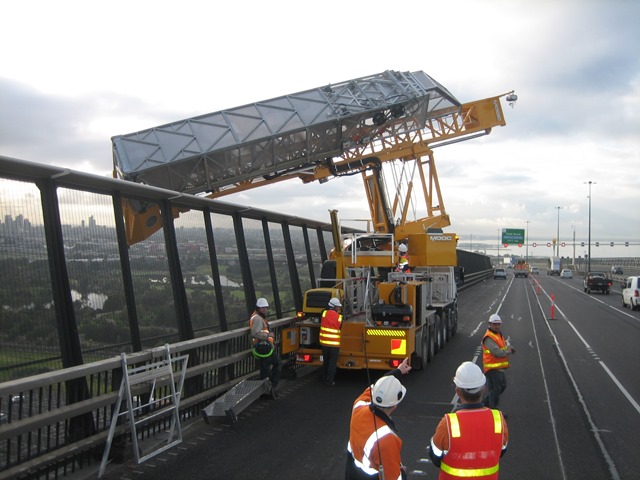

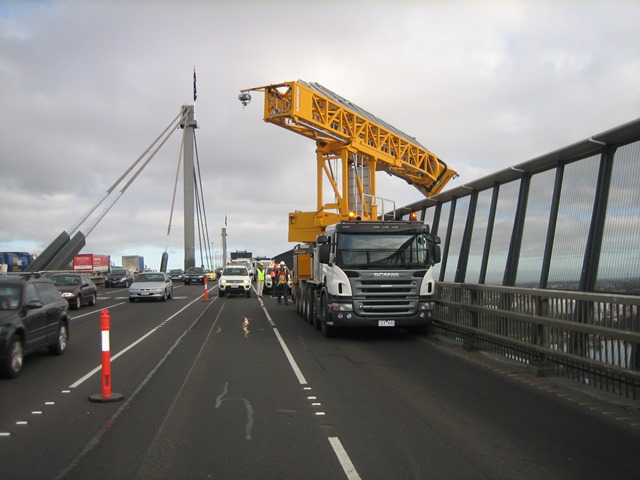

The inaugural use on the West Gate Bridge was scheduled for Saturday 22 September between 6:00am and midday.

Moog GmbH photo

Two lanes of traffic being closed, while the machine was in use.

Moog GmbH photo

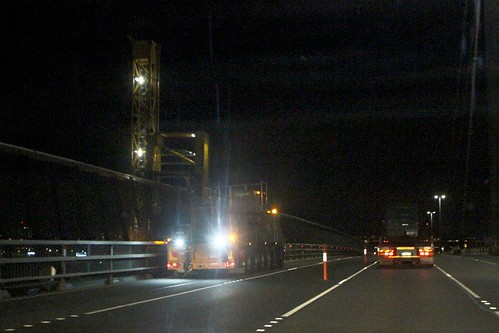

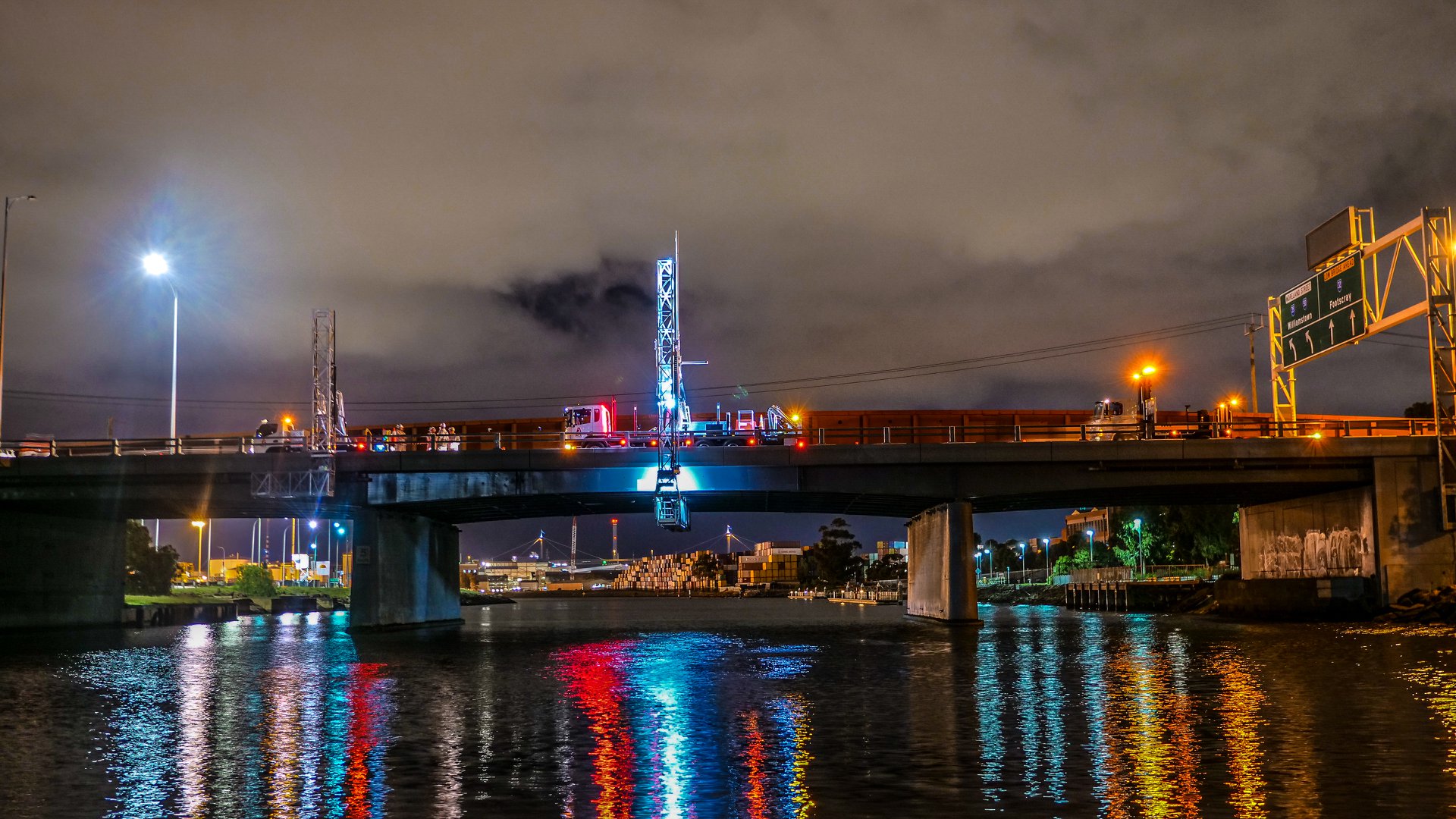

But following the successful commissioning of the unit, it is usually deployed in the dark of night, to minimise the amount of disruption to traffic.

Two outer lanes closed and 40 km/h speed restriction while the MOOG MBI 200 bridge inspection vehicle is deployed to inspect the underside of the bridge deck

Footnote: more details

Some facts and figures

– 12 metres long
– 2.5 metres wide
– 4.4 metres tall
– 37 tonne mass
– 800 kilogram maximum payload
– 20 metre long access platform
– 17 metre long boom arm
– 6 effective axles when in operation

The under-bridge access unit is mounted atop a Scania 8×4 chassis, with two auxiliary axles able to be lowered to provide additional stability to the vehicle while in use, removing the need for outriggers. Movement of the vehicle while deployed is via 200mm diameter hydraulic driven rollers bearing on the top of the one set of tyres, providing accurate creep control.

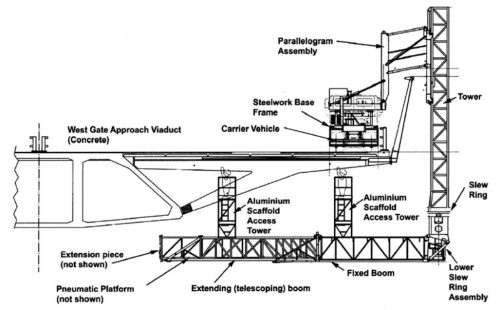

VicRoads diagram

Along the boom modular aluminium access scaffold are provided to give access to the underside of the bridge. Additional equipment includes a 12Kva generator providing 415 and 240 volts to power tools, LED lighting, air compressor, water tank and pump, and a hydraulically operated telescopic lift.

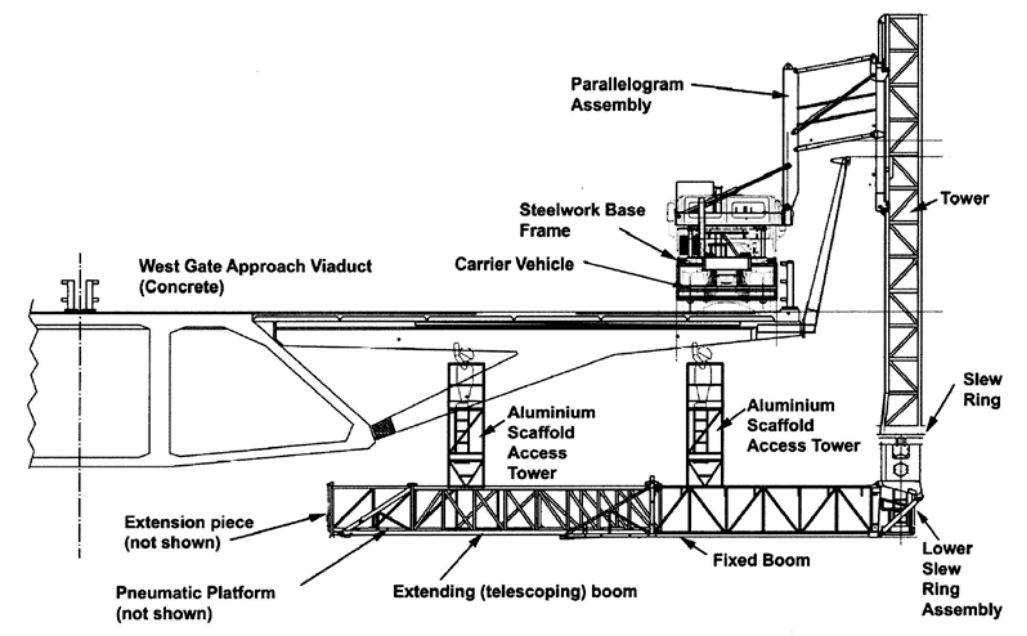

VicRoads diagram

Footnote: and other bridges

The West Gate Tunnel project recently used an under-bridge access unit to inspect Shepherd Bridge in Footscray.

West Gate Tunnel Project photo

But they used a ABC 150/LST unit built by Barin Italy, supplied by Ace Tower Group.
