Melbourne Airport Rail’s trail of destruction

The Melbourne Airport Rail project might be “paused” but it has already left a trail of destruction across Sunshine. Today’s example is the Sunshine to Tottenham shared path.

Shared path closure for service relocation works at Sunshine station extended from 30 April to 30 June 2023

The works notice that never was

The first sign of what was to come was posted on the Facebook page of local state MP Sarah Connolly, who posted a copy of a Melbourne Airport Rail works notice.

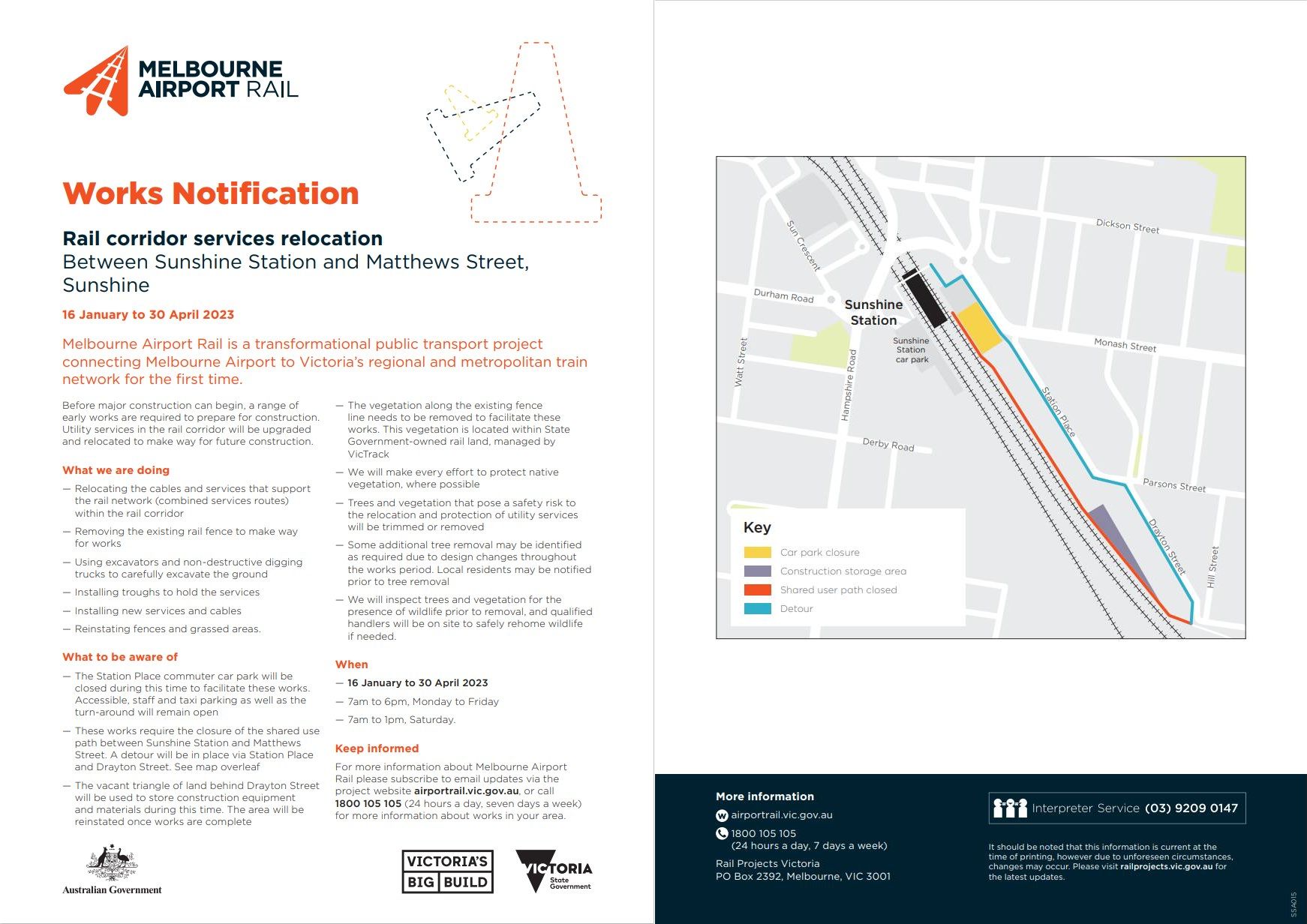

It advised that shared path between Sunshine station and Matthews Street in Station would be closed from January 16 until April 30, with a detour via Station Place and Drayton Street.

Signage soon appeared at Sunshine station telling motorists that a few parking spaces would be closed.

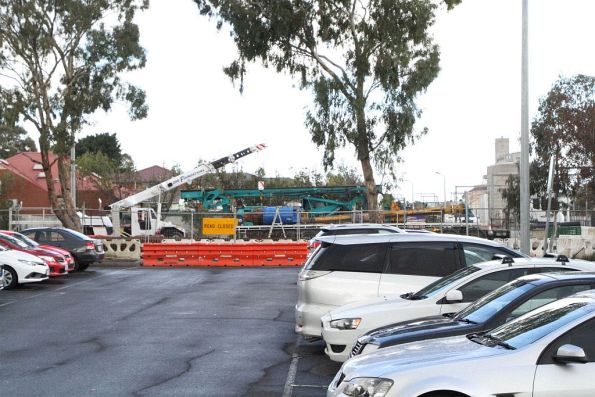

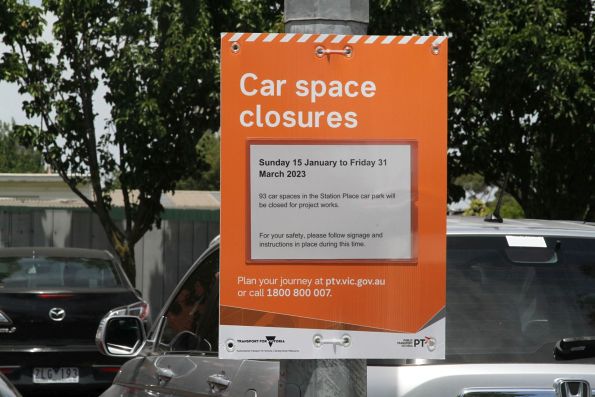

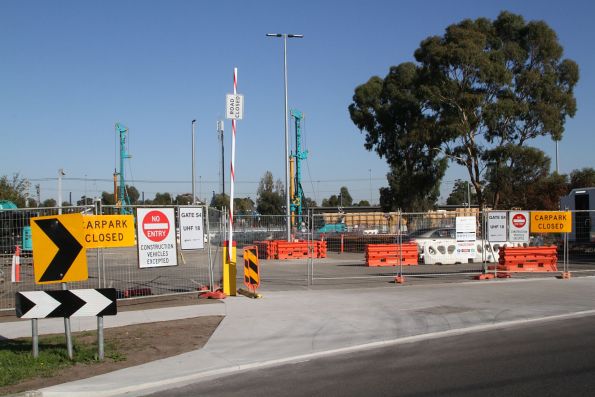

Notice that the Station Place car park at Sunshine station will be closed from January to March 2023 for Melbourne Airport Rail works

But nothing appeared beside the shared path.

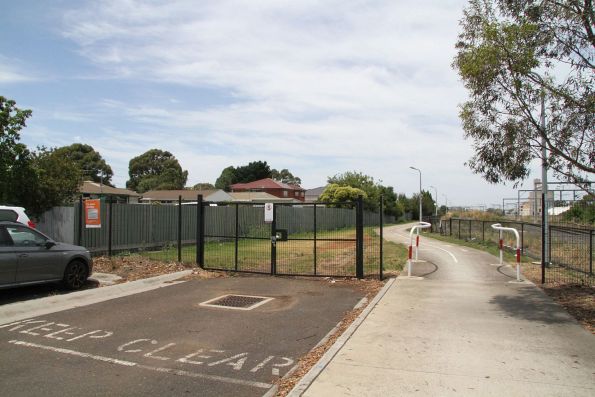

Shared use path between Sunshine station and Matthews Street will be closed until April 2023 for Melbourne Airport Rail works, but no signage in place

Until January 20, when a fence suddenly appeared across the path at Sunshine station.

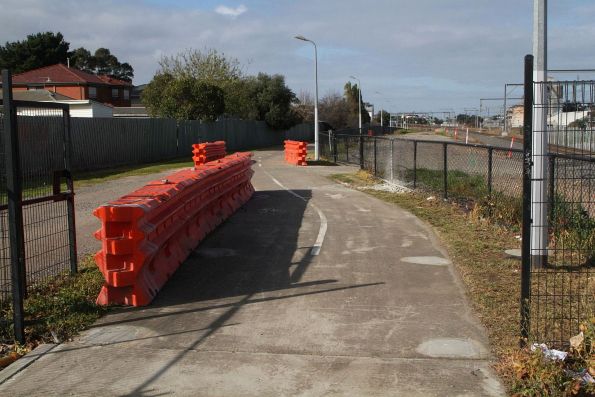

Shared path south of Sunshine station closed for a few months to allow service relocation works to proceed

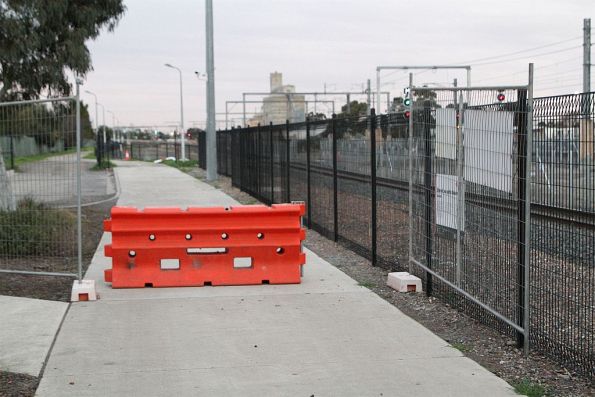

And a ‘footpath closed’ sign across the Matthews Street end of the path.

South end of the shared path closure along the railway at Sunshine

But still no signage from the Melbourne Airport Rail project regarding the path closure – just one abut the removal of trees.

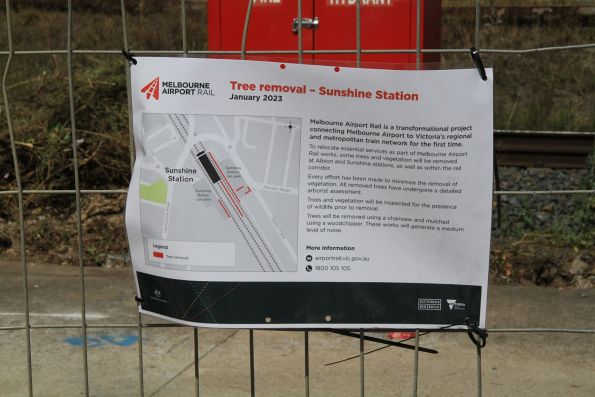

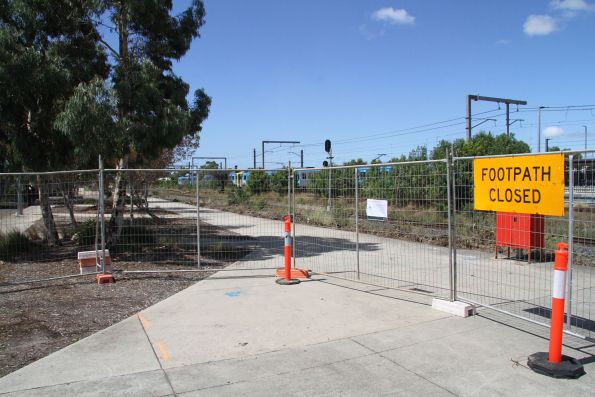

No notice from the Melbourne Airport Rail project regarding the path closure - just removal of frees

Work starts

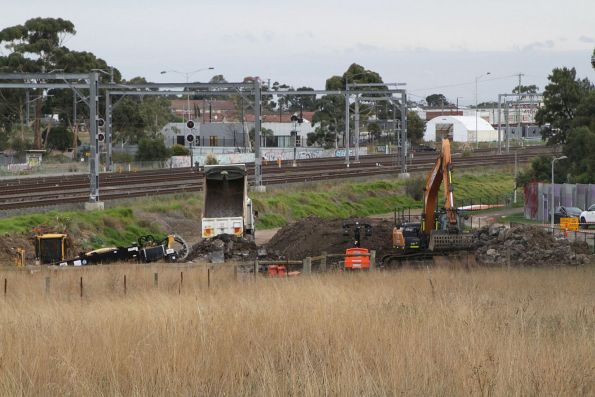

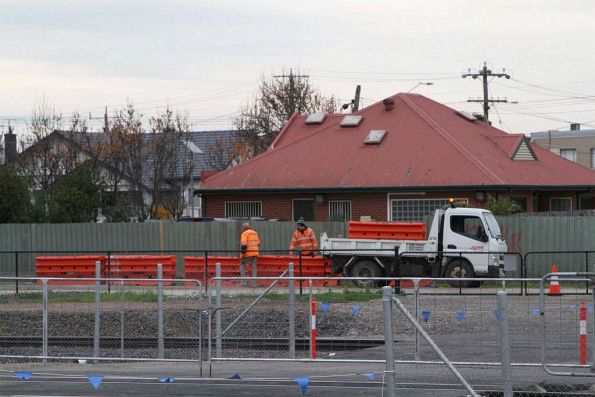

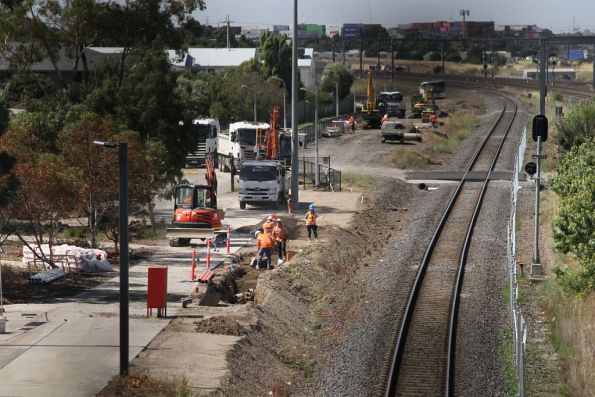

February saw the excavators roll in, installing new signalling and power conduit along the railway line.

Installing new signalling and power conduit beside the standard gauge line at Sunshine

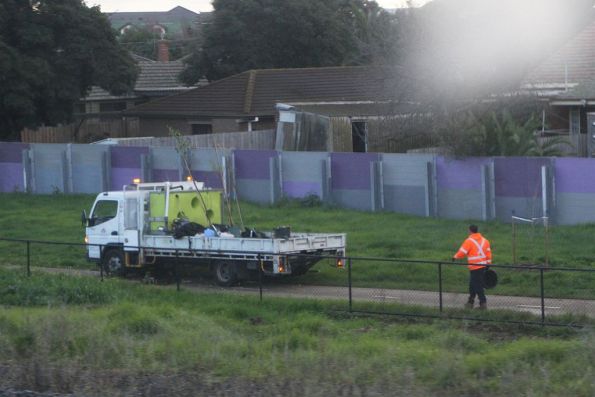

Dumping spoil next to Matthews Hill.
Spoil dump next to Matthews Hill in Sunshine for Melbourne Airport Rail works

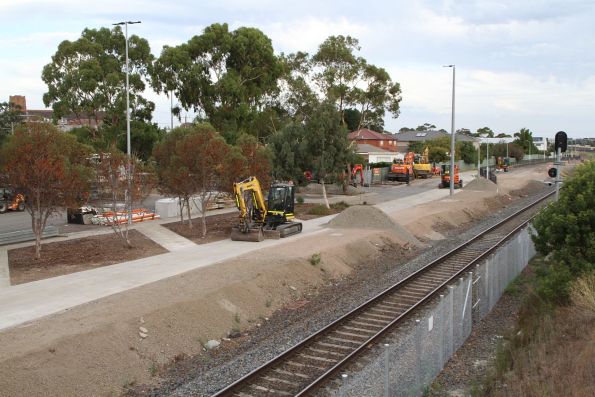

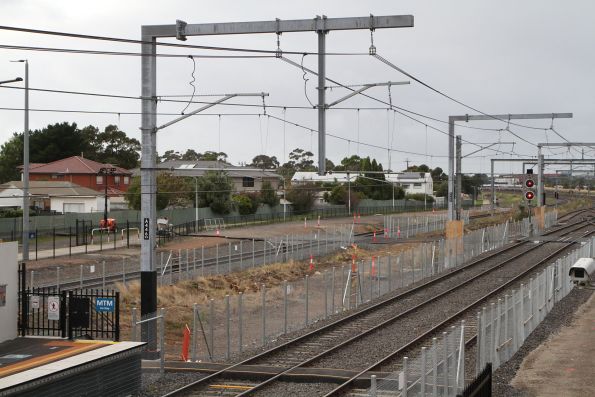

But by March 2023 the new conduits had been installed, and work was underway to restore the shared path to its previous state.

Installing new signalling and power conduit beside the standard gauge line at Sunshine station

The fencing along the railway line back in place, ready for the promised April 2023 reopening.

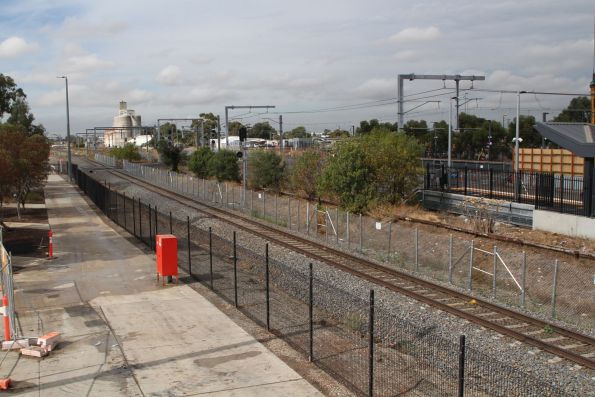

Fencing back in place beside the standard gauge line at Sunshine following service relocation works

And a second closure

Turns out out the April 30 reopening date was a lie – the Melbourne Airport Rail project finally put up a works notice beside the closed shared path, with an updated ’30 June 2023′ reopening date.

Shared path closure for service relocation works at Sunshine station extended from 30 April to 30 June 2023

The shared path now being used as an access point to thenew station concourse that the Melbourne Airport Rail project was due to deliver at Sunshine station.

New driveway on Station Place providing access to the Melbourne Airport Rail work site on the east side of Sunshine station

The trees cleared between the broad and standard gauge tracks were removed.

Trees cleared between the broad and standard gauge tracks at the up end of Sunshine

And the ground levelled out.

Working on the foundations for the future up end station concourse at Sunshine

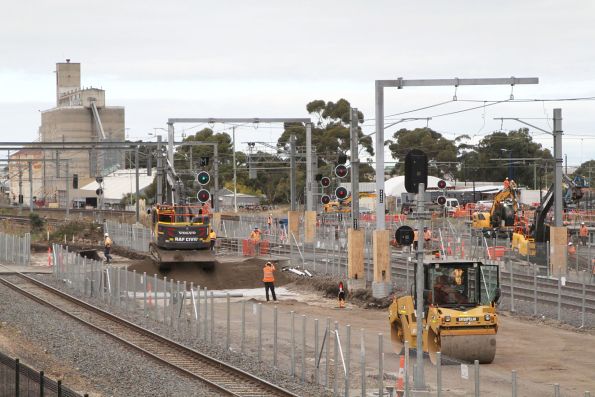

A piling rig was hard at work on the foundations at the end of platform 2.

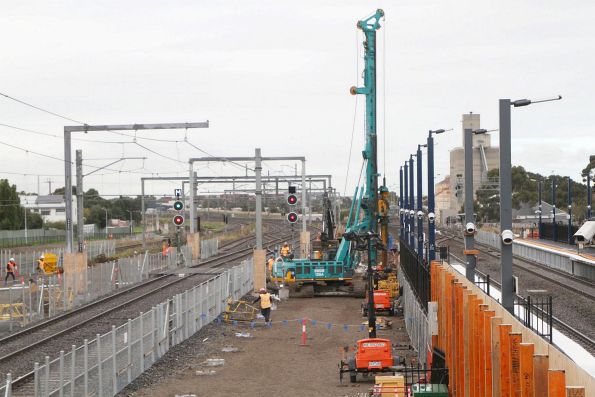

Piling rig continues work on foundations at the up end of Sunshine platform 2

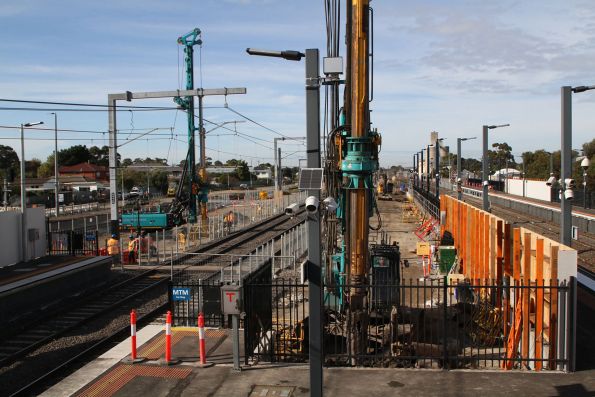

And in May it was joined by a second piling rig working on an extension of platform 1.

Piling rigs at work on foundations at the up end of Sunshine platform 1 and 2

Then on May 17 a bombshell:

Hundreds of tradespeople will be seconded to other projects after the Andrews government confirmed Melbourne Airport Rail Link construction would be paused, awaiting the results of a major Commonwealth review of the country’s infrastructure pipeline.

Deputy Premier Jacinta Allan on Wednesday ended weeks of speculation about the future of the long-awaited rail line, saying works would be temporarily halted on the $13 billion Airport Rail Link.

“States [were] informed that no new contracts to progress works can be entered into during the review period, without express permission of the Commonwealth government,” Allan said in a statement.

“That means projects that are moving from early works packages cannot move to the next phase of works for the review period”

A few days later, the piling rigs at Sunshine station had been packed up and taken away.

Final piling rig packed up and ready to be trucked away from the Melbourne Airport Rail work site at Sunshine station

Leaving a row of completed concrete piles.

Asphalt emergency exit pathways at the up end of Sunshine station following the demobilisation of Melbourne Airport Rail works

But it gets worse

Despite work on Melbourne Airport Rail having wrapped up, the Sunshine-Tottenham shared path was still fenced off, hidden behind a pile of abandoned construction materials.

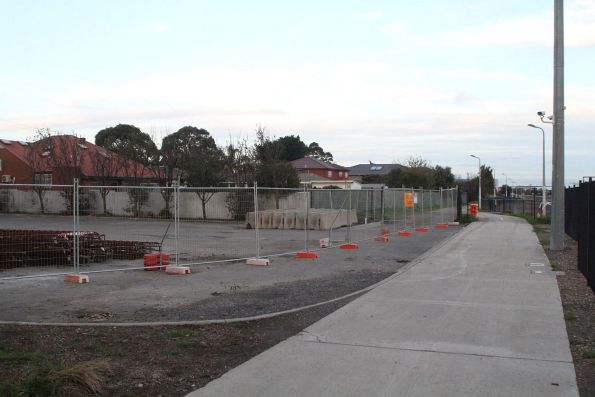

Unused steel reinforcing cages abandoned at the demobilised Sunshine station work site

And then in early June the shared path detour via Station Place was itself closed – so that stormwater pipes leading to Our Lady of the Immaculate Conception Primary School could be upgraded.

Shared path detour at Sunshine station leads to another dead end - Station Place is also getting dug up for unrelated works!

So sick of waiting for the proper path to reopen, someone decided to take matters into their own hands and busted open the fence.

Sick of waiting for the Sunshine-Tottenham shared path to reopen, someone just busted open the fence at Sunshine station

Revealing the mess that the Melbourne Airport Rail project left behind.

Gravel covering the concrete surface.

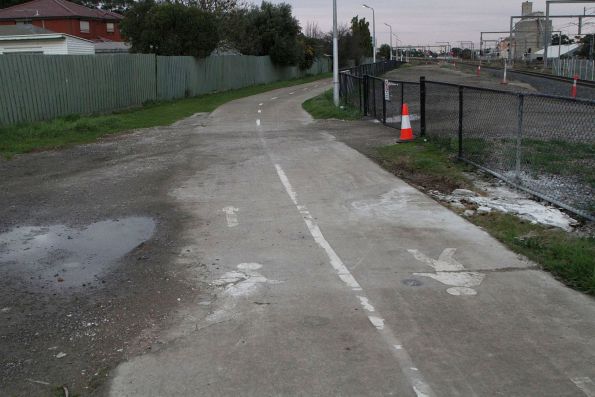

Surface of the Sunshine-Tottenham shared path torn up following Melbourne Airport Rail works

Bits of fence missing between the path and the rail corridor.

Fence missing on the Sunshine-Tottenham shared path following Melbourne Airport Rail works

And the concrete surface cracked from heavy vehicles driving over it.

Surface of the Sunshine-Tottenham shared path torn up following Melbourne Airport Rail works

And a reopening

The first sign of an official reopening was relocation of the temporary fencing away from the path.

Temporary fencing now clear of the Sunshine-Tottenham shared path past the abandoned Melbourne Airport Rail work site at Sunshine station

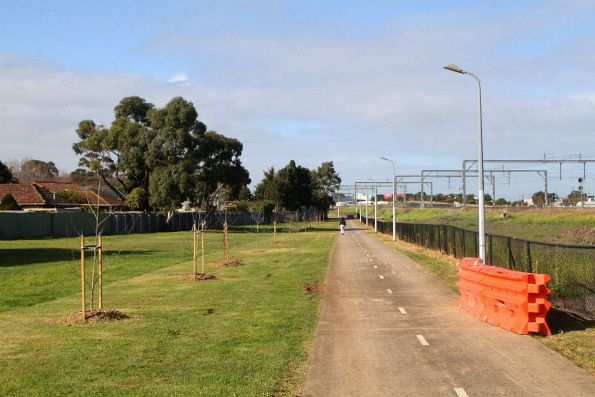

And a Brimbank City Council contractor planting new trees along the shared path.

Citywide Services contractor plans new trees along the Sunshine-Tottenham shared path

A John Holland work crew then placing crash barriers along the damaged sections of path.

John Holland crew placing crash barriers along damaged sections of the Sunshine-Tottenham shared path

Covering the gravel that littered the concrete.

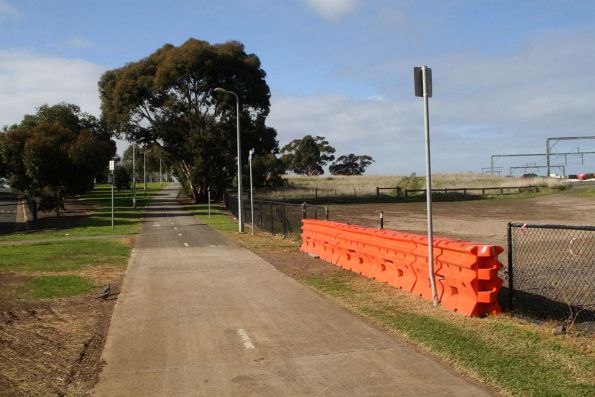

Crash barriers cover areas of the Sunshine-Tottenham shared path surface destroyed by Melbourne Airport Rail works

The concrete broken by heavy vehicles.

Crash barriers cover areas of the Sunshine-Tottenham shared path surface destroyed by Melbourne Airport Rail works

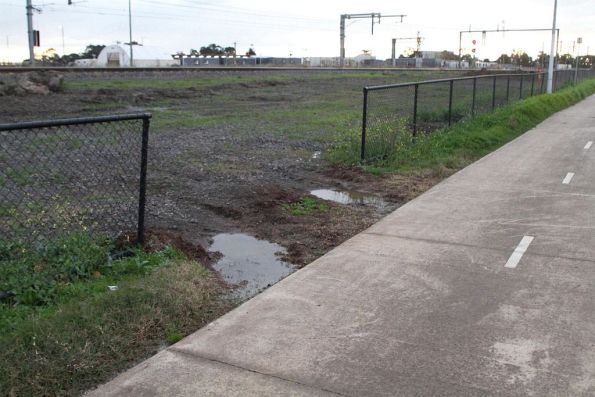

Mudholes beside the path created by careless drivers.

Crash barriers beside the Sunshine-Tottenham shared path cover a muddy bog created by Melbourne Airport Rail workers

And replacing fences destroyed by excavators.

Crash barriers beside the Sunshine-Tottenham shared path replace a fence destroyed by Melbourne Airport Rail works

So what will happen first – restoration of the shared path to original condition, resumption of work on Melbourne Airport Rail, or the entire project being cancelled?
